The best SMR developer of 2026 is still the one pouring concrete: GE Vernova Hitachi, whose BWRX-300 is in construction at Darlington with an operating licence application already filed. TerraPower tightened its chase on August 14 with a Korean fleet EPC agreement that could finally bring completion and price guarantees to advanced-reactor construction. Rolls-Royce SMR completes the podium. This ranking scores the 127-design field on hard evidence only — construction starts, licences in hand, and firm, funded orders — not renderings or memoranda of understanding.
Key facts
- The NEA counts 127 SMR designs worldwide; fewer than a dozen have steel in the ground or an application in formal regulatory review
- Ranking criteria, in order of weight: nuclear construction underway, licences granted, licence applications docketed, firm funded orders, fuel-supply readiness
- Two Western SMR-class plants are in nuclear construction: Darlington's BWRX-300 and TerraPower's Natrium
- Four DOE-authorized microreactors reached first criticality by July 4, 2026; Oklo's Groves reactor reached first criticality on August 6
- Data as of August 15, 2026; every status below links to a primary source

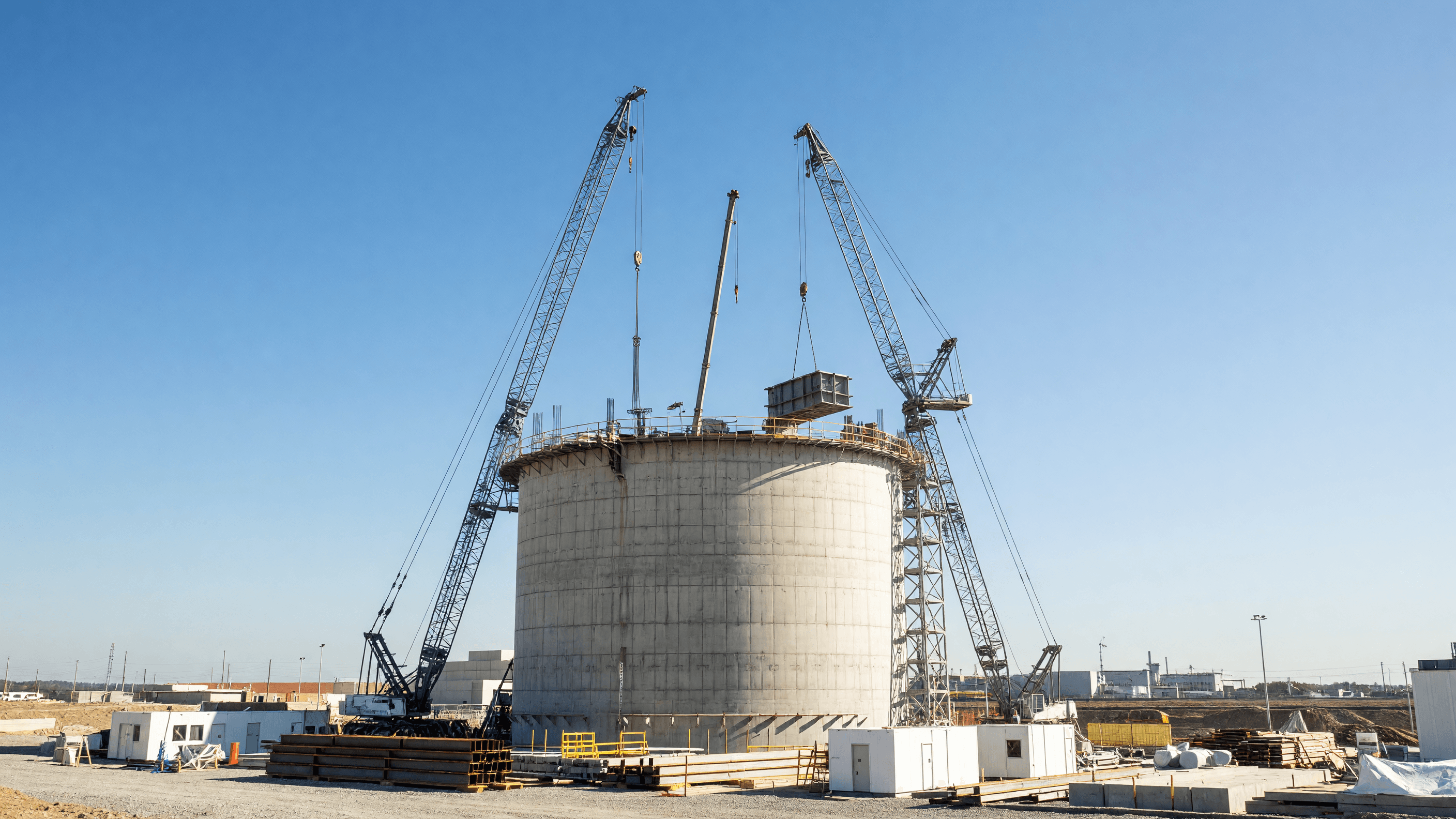

1. GE Vernova Hitachi — BWRX-300
The only developer with a Western SMR in construction and an operating licence application on file. Unit 1 of four at OPG's Darlington site in Ontario is in civil construction with first power targeted for the end of 2030, and OPG has applied to the CNSC for a 20-year operating licence. The order book is the deepest in the field: TVA's Clinch River construction permit cleared its NRC safety evaluation in June 2026, and Poland's Orlen Synthos has applied for state backing for 14 units across three sites — the first phase of a program targeting 26. The BWRX-300 also cleared UK GDA Step 2 in December 2025. Its edge is boring on purpose: standard fuel, boiling-water heritage, and repetition.
2. TerraPower — Natrium
The most advanced advanced reactor got a fleet-scale construction partner on August 14, 2026. Natrium — a 345 MWe sodium-cooled fast reactor with molten-salt storage that flexes to 500 MWe — holds the NRC's first modern commercial fast-reactor construction permit (March 2026) and began nuclear construction at Kemmerer, Wyoming on April 23, 2026. The new development is a framework agreement with Hyundai Engineering & Construction that makes HDEC the EPC contractor for up to eight future Natrium reactors in the United States and selected international markets, with completion, price and performance guarantees designed to enable conventional commercial financing. A separate term sheet with SK Innovation targets Korea's first commercial Natrium plant. Bechtel remains the EPC contractor for Kemmerer Unit 1; the HDEC deal is for the fleet beyond first-of-a-kind. The Meta agreement covering up to eight plants for data centers and the UK GDA entry remain in place. It ranks behind GVH only because the Korean framework is not yet a docketed construction start and first-of-a-kind risk still sits between Kemmerer and a fleet.
3. Rolls-Royce SMR
The biggest balance sheet behind any Western SMR program. In April 2026 Rolls-Royce SMR signed the delivery contract with Great British Energy - Nuclear for three 470 MWe units at Wylfa in Wales, backed by over £2.5bn of UK government commitment and a National Wealth Fund loan facility. It is the only design in active Step 3 of the UK's Generic Design Assessment, and ČEZ signed early-works contracts in April for up to six units at Temelín in Czechia. No nuclear construction yet — which is the only reason it isn't higher.
4. Oklo
Nobody has moved faster from dirt to operating chain reaction. Oklo's Groves Isotope Test Reactor in Lockhart, Texas received DOE startup authorization on July 23, 2026, then reached first criticality on August 6 — a controlled, self-sustaining chain reaction less than a year after groundbreaking (NNN's coverage). Its Aurora-INL plant broke ground in September 2025, and the NRC approved its principal design criteria in half the usual review time in May 2026. The caveat that keeps Oklo at four: everything built so far runs under DOE authorization on federal or private land, and the NRC combined licence for commercial Aurora plants is still ahead of it.
5. X-energy
The quiet supply-chain leader strengthened its fuel link on August 6, 2026. The Xe-100 construction permit for Dow's Seadrift, Texas site cleared its environmental review in May 2026 with the final NRC safety evaluation due in November — and X-energy's TRISO-X subsidiary holds the first-ever NRC Part 70 licence for HALEU fuel fabrication. The new Centrus agreement covers phased LEU and HALEU enrichment services from the American Centrifuge Plant in Ohio for part of X-energy's initial Xe-100 needs. Amazon anchored a ~$700m raise targeting more than 5 GW of Xe-100 projects, including the Cascade project with Energy Northwest in Washington state. Owning your fuel plant and a named enrichment route is a moat nobody else in this list has.
6. Kairos Power
The iteration machine. Hermes 1 has been in safety-related construction at Oak Ridge since May 2025, and Kairos broke ground on the two-unit Hermes 2 plant in April 2026 — the first power-producing Gen IV reactor with an NRC construction permit, and the first deployment under its 500 MW master agreement with Google, delivered via TVA's grid. Kairos builds test hardware in-house and treats each unit as a learning cycle; its NRC reviews keep finishing early. What it lacks is a commercial-scale order book.
7. NuScale / ENTRA1
Still the only company with NRC-approved SMR designs — the 50 MWe module certified in 2023 and the uprated 77 MWe US460 approved in May 2025. The long-awaited first project finally firmed up in February 2026 when Romania's RoPower took a final investment decision on the six-module, 462 MWe Doicești plant. ENTRA1, its commercialization partner, is working with TVA on planning for up to 6 GW. The gap between paper leadership and construction leadership is the story of NuScale's decade; Doicești is its chance to close it.
8. Holtec
A licensing two-track. Holtec filed the first phase of its SMR-300 construction permit for the Palisades site in Michigan on the last day of 2025, and the NRC opened the environmental review in June 2026 — on the same campus as the restarted Palisades large reactor. In the UK it completed GDA Step 2 in March 2026 and is pursuing the ~$11bn privately-financed Cottam project. Holtec's differentiator is the restart-plus-newbuild combination; its constraint is that no SMR-300 construction has started anywhere.
9. Westinghouse — AP300
Still the field's biggest paper tiger, honorably. The AP300 packages proven AP1000 passive safety into 300 MWe, but it remains in NRC pre-application three years in, and its once stated 2027 design-certification target has not been reaffirmed. An August 2026 pact with Amentum aims squarely at accelerating NRC approval. Westinghouse's nuclear muscle is currently pointed at AP1000s — including the DOE-backed 10-unit program — which is rational, and exactly why the AP300 ranks ninth. See how it stacks up in BWRX-300 vs AP300 vs Natrium.
10. The microreactor insurgents — Aalo, Antares, Valar, Radiant, Last Energy
The DOE Reactor Pilot Program produced 2026's most startling stat: four test reactors reached first criticality by July 4 — Antares' Mark-0, Valar Atomics' Ward 250, Deployable Energy's Unity and Aalo's Aalo-X. Oklo's Groves added a fifth on August 6. These are zero-power test units under DOE (not NRC) authorization, so they aren't yet commercial plants — but as a class they compressed the build-learn cycle from a decade to a year. Aalo is now teasing a one-million-square-foot factory to mass-produce Aalo Pods and says its 10 MWe Project Ascension reactor will power an on-site data center at INL in 2027. Radiant's Kaleidos is fueled and awaiting full-power testing at Idaho's DOME test bed; Last Energy is piloting at Texas A&M. One of these names will be on next year's top five.
Side by side
| Rank | Developer (design) | Output | Hard evidence as of Aug 2026 |
|---|---|---|---|
| 1 | GE Vernova Hitachi (BWRX-300) | 300 MWe | In construction (Darlington); operating licence filed; TVA SER done; 14-unit Polish CfD filed |
| 2 | TerraPower (Natrium) | 345/500 MWe | NRC construction permit; nuclear construction since Apr 2026; HDEC EPC framework for up to 8 units; SK Innovation term sheet |
| 3 | Rolls-Royce SMR | 470 MWe | Signed UK contract for 3 units at Wylfa; GDA Step 3 |
| 4 | Oklo (Aurora/Groves) | 15–75 MWe class | First criticality Aug 2026; DOE startup authorization Jul 2026; Aurora-INL site work |
| 5 | X-energy (Xe-100) | 80 MWe/module | CP in final NRC review; only licensed HALEU fuel plant; Centrus LEU/HALEU enrichment agreement |
| 6 | Kairos Power (Hermes) | ~50 MWe (Hermes 2) | Hermes 1 + 2 in construction at Oak Ridge; Google deal |
| 7 | NuScale/ENTRA1 (US460) | 77 MWe/module | Only NRC-approved designs; Romania FID Feb 2026 |
| 8 | Holtec (SMR-300) | 300+ MWe | Palisades CP filed; UK GDA Step 2 done |
| 9 | Westinghouse (AP300) | 300 MWe | NRC pre-application; Amentum licensing pact |
| 10 | Microreactor tier | 1–20 MWe | Four DOE-authorized criticalities by Jul 4, 2026; Aalo factory-scale push |
How to read this ranking
Construction beats certification, and certification beats announcements — that's the whole methodology. It is why NuScale, with the field's only approved US designs, sits below five companies with fewer approvals and more concrete. For the broader context — what counts as an SMR, and why serial production is the entire economic bet — start with the complete SMR guide, then the running list of every US nuclear plant under construction. This page is refreshed quarterly; statuses above are dated August 2026.
Questions
- Which SMR company is closest to building a working reactor?
- GE Vernova Hitachi. Its BWRX-300 unit 1 is in civil construction at OPG's Darlington site in Ontario, an operating licence application is already before the Canadian regulator, and first power is targeted for the end of 2030.
- What are the top SMR companies in the US?
- By deployment progress: TerraPower (Natrium under construction in Wyoming, plus a Hyundai E&C fleet EPC framework for up to eight future units), X-energy (Xe-100 construction permit in final NRC review, fuel plant licensed and a Centrus HALEU supply agreement), Kairos Power (two Hermes units in construction at Oak Ridge), Oklo (first criticality at the DOE-authorized Groves test reactor in Texas), NuScale (the only NRC-approved SMR designs) and Holtec (Palisades new build in NRC review).
- How many SMR designs exist worldwide?
- The OECD Nuclear Energy Agency's latest dashboard counts 127 SMR designs, 74 of them in active development. Fewer than a dozen have steel in the ground or a licence application under formal review — the gap this ranking measures.
- Are any SMRs actually operating yet in the West?
- No Western commercial SMR is in power operation yet. The closest are Darlington's BWRX-300 (construction, operating licence filed) and a wave of DOE-authorized microreactor test units — four reached first criticality by July 4, 2026, and Oklo's Groves reactor added a fifth first criticality on August 6.
Sources
- OPG applies for operating licence for BWRX-300 SMR — World Nuclear News
- TerraPower Commences Construction on America's First Utility-Scale Advanced Nuclear Power Plant — TerraPower
- TerraPower Accelerates Natrium Reactor Deployment Following Landmark Meetings with Korean Leaders — TerraPower
- Rolls-Royce SMR secures contractual certainty to build Europe's first SMR fleet — Rolls-Royce SMR
- Oklo's Groves Reactor Achieves First Criticality in Under a Year — Oklo Inc.
- X-energy, Centrus Sign HALEU Supply Agreement for Xe-100 Advanced Small Modular Reactor Development — X-energy
- Aalo Achieves Criticality — Aalo Atomics
- Romania's coal-to-NuScale SMR conversion secures FID — POWER Magazine
- Kairos Power breaks ground on Hermes 2 demonstration plant — Kairos Power
- Department of Energy celebrates fourth criticality ahead of July 4th goal — US Department of Energy
- There are now 127 different SMR designs, finds NEA report — World Nuclear News
About Nuclear News Network
Nuclear News Network (NNN) is an independent publication covering the global nuclear energy sector — reactor construction, SMRs, fuel supply, policy, operations and fusion. NNN publishes a daily brief, same-day analysis of major developments, and reference guides used across the industry. Articles are produced by the NNN Newsroom, an editorial automation system with human oversight, under the publication's editorial standards.
